Next Steps

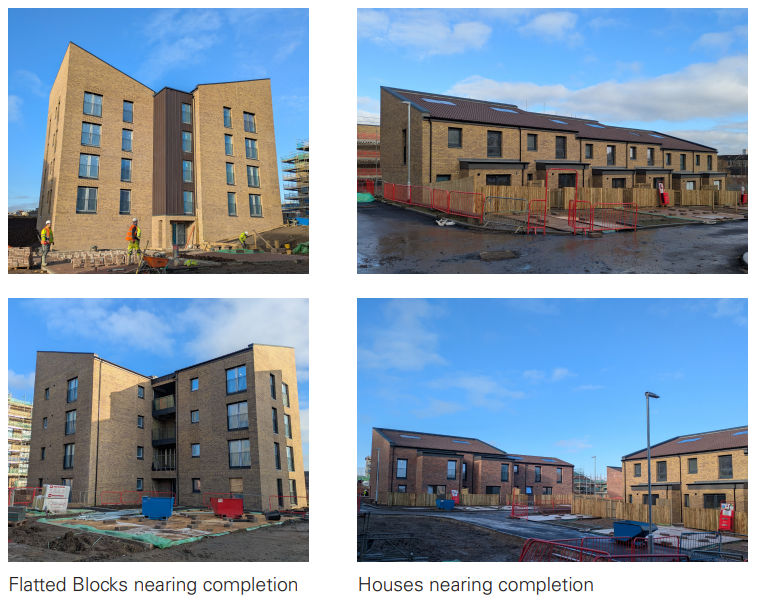

The Phase 1 Housebuilding works are underway and due to complete in 2026. The development is predominantly constructed in timber kit, with steel frame communal closes to flats.
The blocks within Areas 2, 3 and 6 comprise a mix of 3-4 storey flats, 2 storey terraced houses and cottage flats. Timber kits, window installation, external brickwork and roof tiling are progressing as well as internal joinery, plumbing and electrical installations.
Areas 1 and 4 (between Bardowie Street and Tannock Street) will provide terraces of houses and cottage flats.
Area 5 will provide two-storey terraced houses for private sale and will be the last the complete within Phase 1.

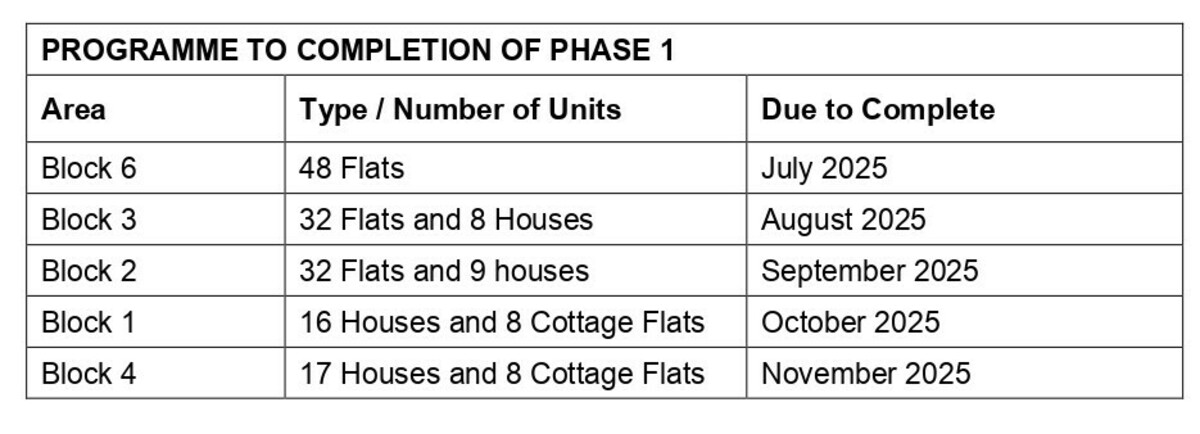

Planning for phase 2 is underway, with a site start expected in July 2025.
We'll continue to keep residents up-to-date throughout each stage of the development with regular updates to the website and social media.
For further information on private home sales get in touch with Urban Union on 0141 530 4000 or email info@urbanunionltd.co.uk.
